9 Answers, 1 is accepted
There are two thing that you could do in your situation depending on the case.
The best way is to split the story into two stories. You can mark the old story as done and create a new story for the new iteration. You will have to move the undone task to the new story.
Anyway in some cases it is not possible to split the story, so you should move the whole story to the new iteration. Note that task marked as Done or Deleted will not move to the new iteration.
It's up to you which method you should use.
If you have any other questions feel free to ask us at any time.
Regards,
Ivan
Telerik
So my burndown chart is now going to start at 339 when, in reality, I only have 323 total hours of work.
How can I solve this?
From your email it looks like you are using a burndown by Estimate and in this case the tasks estimates won't be used in the burndown calculation. To use tha task estimated for the burndown calculation you will need to change the burndown mode to Task estimate. You can change the default burndown mode from the Reporting Settings tab in the project settings and you can change the burndown mode for a single report from the Burndown mode dropdown in the reports settings or in the iteration status page. Here is more information on the difference between the burndown types: http://docs.telerik.com/teampulse/project-administrator-guide/reporting-settings
So in order to move the story to the new iteration and keep only the remaning 3 hours in the calculation using the burndown by Task Estimate, you need to have the completed 16 hours within other tasks all set to done (which will mark the tasks as completed) and the 3 hours into task(s) in status different from Done or Deleted. Thus, the tasks with status Done (with total estimate of 16 hours) will remain in the past iteration, and the task with estimate of 3 hours will be moved into the new iteration. The estimation set for the story won't be calculated in the burndown report.
You can find a more detiled information on how to use the PERT task estimate here.
Please review the settings of your burndown report and let us know if your setup is a different one so we can suggest a different solution.
Regards,
Zornitsa
Telerik

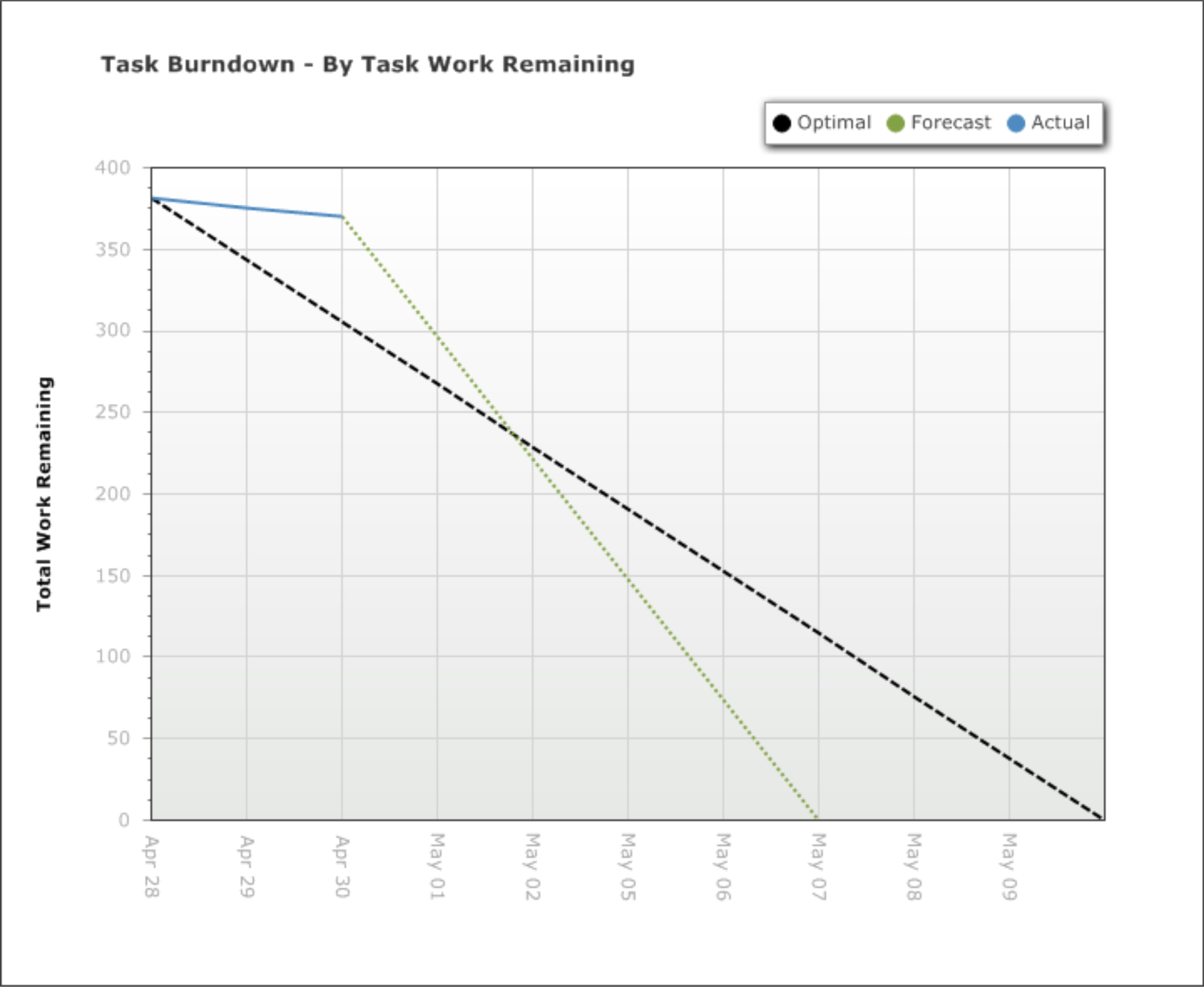

Also, on the burn down charts, and this is a huge problem, my forecast line is WAY off. How is this calculated. Based on our current burn rate, we are behind schedule, but the chart predicts us being done several days early. This is causing extreme frustration when trying to report project status. I have attached my report file.
I have noticed that your burndown calculation is a forecast one - this new calculation mechanism was introduced as a replacement of the previously used trend mechanism to improve the handling of increasing the remaining work by adding new work items. The difference between the trend and the forecast mechanism if that the forecast mechanism doesn't predict the addition of new work based on the work added before and calculates the forecast based on the work remaining at the moment and the current trend for completing tasks.
As breaking the stories into tasks, usually done during the first few days of the iteration, often leads to adding new work and setting more precise estimations, the about even or sometimes even upwards slope of the actual line in the burndown is normal and the forecast will be downwards because the prediction doesn't follow the upwards slope from the new work added.
The Iteration planning screen used by default estimates for the capacity calculations presented on the iteration cards. However, the burndown mode used in the Iteration status screen and in the reports is the default mode selected in the project settings.
Do not hesitate to get back to us if you need any further assistance.
Regards,
Zornitsa
Telerik
Hello Phil,
Did you have a chance to check the burndown again after a couple of days?
The forecast algorithm is based on the velocity in the Iteration up to the moment and the speed could be faster or slower in the beginning of the iteration if the velocity for the first day has been higher/lower than the average for the whole period. Basically, the forecast is getting more precise the further in the iteration we are because the velocity is calculated based on more data points and the forecast in the beginning of the iteration may not always be reliable because of the limited data. However, this highly depends on how even the workload is spread and the correct logging of the data. Also, please keep it in mind that the estimates may differ from the actual time spent on the separate tasks and these differences may also speed up or slow down the burndown.
Please review the burndown again and let us know if you have any concerns on the algorithm used.
Regards,
Zornitsa
Telerik
I would prefer a way to have the forecast simply be the average slope over the iteration as projected from the current day onwards in the future, if this is possible.
Thank you very much for your detailed feedback on the burn rate calculation. It is a valuable input for us.
We will need to discuss this matter internally and we will get back to you next week.
If you have any other questions or ideas, feel free to write us at anytime.
Best regards,
Zornitsa
Telerik
